Delta Design and Construction

Delta Design and Construction

Delta Design and Construction
2.3

4 reviews

Positive vs Negative
25%25%50%
Build Stage
  • Mid-Construction
  •  ·
  • Post-Construction
Customer Service
2.3
Site Admin ?
1.7
Timeliness
1.0
Structural Integrity
4.0
Plumbing & Waterproofing
2.0
Electrical & Lighting
2.0
Flooring
4.0
Transparency ?
1.3
Brand Manager for Delta Design and Construction? Claim your listing.
NeilG
NeilGNSW8 posts
  Verified ACT

Please Avoid as they have abandoned the build and not paid subcontractors – Please don’t sign any contracts with this company. Along with us they have abandoned several new building contracts in ACT. We have also discovered that both directors have been declared bankrupt and the the company Delta Design and Constructions has not paid several subcontractors in relation to our build, and that the company owes many of its suppliers so appears to be insolvent. Please avoid.

  • Build Stage: Mid-Construction
Mys
MysACT2 posts
  Verified ACT
Structural Integrity
Plumbing & Waterproofing
Electrical & Lighting

Please don't go with them – They are the worst builder I've ever encountered. They built the house incorrectly, failed to comply with the deadlines, using low quality standard items and to the worst they took your money and never came back. So think twice before you engage them or you will end up spending more fixing things up yourself. It costs you emotionally as well. Trust me or you are more than welcome to experience it yourself in reality.

  • Build Stage: Post-Construction
Super Demolition Pty Ltd
Super Demolition Pty LtdNSW2 posts
  NSW

Perfect – Great Builder, very professional, quality homes, amazing Designs. It was a great pleasure working with them, A painless experience. I recommend them to every family thinking to build the dream home.

  • Build Stage: Mid-Construction
  • Construction End Date: October 2019
  • Thumbnail
  • Thumbnail
  • Thumbnail
K-FAM
K-FAMACT63 posts
  Verified Delta Design and Construction

You decide – We were first home buyers and excited at the prospect of having our home built by someone, we were told by the real estate agent, "someone who just wants to see a smile on your face". Sadly this statement proved to be far from the truth. In reality, the whole experience was more stressful than anything previously experienced in our lives - and that is really saying something. There were no congratulations, flowers, or champagne when the house was finally turned over to us either. No compensation for the excessive length of the build. No concern shown when we made the case seven months into the build that we were going backwards financially and begging for the house to be finished quickly (still took another 4mths and rarely a tradesman on site in the best weather). Not only were we sustaining the duel rent and mortgage payments, but we were also down to a single income as the house was not finished by the time school started in January 2017 (advised it would be), so we had already moved the children to schools near the new house. For the next five months I was required to spend up to six hours a day ferrying the children across town, adding 600kms to our weekly school run, and over $300 per month to our petrol bills. This travel and upheaval also added to the stress that our youngest child (9yrs old with Autism) experienced in his daily life, thereby impacting our stress levels too. Here is our timeline:

October 2015: Deposit December 2015: Exchanged contracts February 2016: Land released by Land Authority 12 April 2016: Land settlement completed. 30 June 2016: Building Approval given 06 July 2016: Issue of Commencement Notice 21 Feb 2017 : Meeting with builder to request hurry up due financial hardship. Promised 6 weeks. 15 June 2017: Builder hands over house.

Frustrations During The Build:

.Requested elevation drawings from exchange onward but only furnished at framing stage. Advised they were not completed each time I asked.

. Requested information re: holdup to BA. Builder stated he had to make a 'minor correction' necessary to gain BA but would not elaborate on what that was..just kept stating it was nothing important.

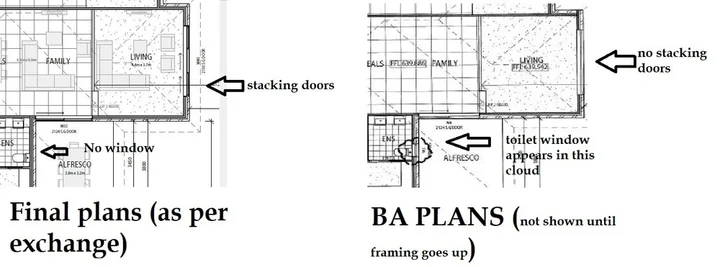

. Discovered at framing stage that the 'minor correction to BA' was the addition of a window from the ensuite (toilet directly under window) opening out into the alfresco dining area. Builder refused to change it to a skylight when requested.

. Stacker doors that were agreed upon at Exchange (to replace a window) and written into the contract and drawn onto updated plans, were not ultimately provided. Builder gave framers an earlier set of plans instead of the newly amended plans. When the error was brought to his attention the builder argued that: a) it would hold up the build by another month if he had to make the change (we were already many months behind schedule); and, b) he stated it would be too difficult to get the framing right for the stacker doors now.

. Builder exceeded 180 day contracted build but refused to reduce final payment. Never given a Variation Notice ever (as stated in contract).

Things brought to builder's attention at 90day warranty in September 2017 but not yet addressed (it is March 2018 as I write this): . 9 months after moving in we still do not have our long concrete driveway with drain across (we own a 30m x 4m strip of land from road to boundary as we are on a battleaxe block). Our neighbour is also on a battleaxe block and also owns a 30m x 4m strip of land from road to boundary, and also does not have his long concrete driveway yet. We share the same builder, as do the two neighbours in front of us who have the street frontage, however the builder managed to give them their shorter concrete driveways as per their contracts. . In December of 2017 the builder offered to compensate us for the driveway. He did not mention a per-metre figure but stated he would only pay for a 1.75m wide driveway. Car won't even fit on that. All other battleaxe driveways in our street consist of two driveways average 3m width each. . No hot water comes through the kitchen tap so all dishes require the dishwasher or a boiled jug. Neither builder nor plumber ever mentioned this problem, we only discovered it after we moved in. The building inspector has obviously issued a Building Certification despite this defect. . Shower in main bathroom is not sealed at ground level and water floods out when shower is used. Building inspector flagged this before Certificate of Occupancy but builder has not yet repaired it. . Smoke detector was placed 6 feet from cooktop in kitchen (despite the instructions stating not to install in kitchen area) and was excessively vigilant to all forms of cooking, forever going off. Ultimately we spent hundreds ourselves to remediate. . Paint used on walls is unwashable despite contract stating it should be washable and Wattyl representatives stating it should be washable. Washing it leaves nasty dark patches and any liquid is absorbed permanently. Even end-of-build-cleaners stopped washing the walls halfway up because they were quite obviously making it worse. . Several walls are significantly marked with a strange linear pattern underneath the paint and it shows through (I will attach pictures if it is possible to do so). Walls will require remediation and repainting. . Selection of kitchen cabinets was left too late to make any necessary configuration changes such as microwave cavity and wall oven as electricals were already in place. . Appliances chosen by builder came to less than the $2500 that the contract stated we had access to but there was no compensation or refund. Light on extraction fan stopped working a few months in and despite discussions with builder about venting we moved in to discover no external venting and not even any absorbent matting in it. . Had to involve real estate agent in negotiations regarding promises made on the Allhomes ad that builder didn't appear to us to want to honor. . Still missing a drain on the northeast side of the house that floods when it rains. . Still missing the concrete pad that should sit underneath a washing line outside of the laundry. . Still missing the tiling to the front porch area. (We expect all the missing things as we have paid for them in the contracted amount and we paid full amount). . Builder forgot to put the plumbing in for our in-wall cistern in ensuite until I raised it after the tiling was done. We were offered a cheap standard toilet instead but it doesn't even seem attached to the wall or floor as it sometimes moves. . Builder forgot the gas connection outside, and also the outside power point but did remediate once we advised. . Builder forgot that the plans stated 4000L water tank, was going to install a 2000L tank instead. . Paid $2200 cash to builder for ground works that ultimately were not completed exactly as negotiated. . Paid extra for bedroom doors we hadn't even requested (builder misread multiple emails clearly outlining our choices for 'custom SLIDING/POCKET doors' as per contract). He mistakenly bought the custom doors for all the internal doors. (Once again, builder stated it would hold up build if we made changes..this was in late 2016..we were told we would likely be in by xmas that year. If we had known we wouldn't actually be in until June of the next year we would have halted the build and had all the errors corrected). Hindsight is always 20/20 though. . There are other niggly things like what we consider to be 'fell off the back of a truck' electronic door lock that was made in Korea but never meant for export as everything is written in Korean..or the thermostat on the airconditioner that shows 'restricted' for most functions like the setting of time zones...and the washing line being placed where the sun barely gets to...no drain cover over the pipe in the front garden bed..scraped topsoil was promised to be kept so we could cover block after build but were only left rock/clay layer of excavation.. etc..etc..etc.

Things Builder Did Fix In 90day Warranty Period: . Fencing between neighbour and us could not be completed at the time the rest of the fencing was done (neighbour needs to complete retaining wall). Builder stated will give us the money for our portion but as yet we have not received anything. . Powerpoints and light switches feel cheap and nasty. Builder did send electrician to fix one as it was so damaged we could not plug our fridge in when we moved in. . Builder also sent tiler to grout some of the tiling that was missed. He also sent someone to put a hole in the laundry cabinet so that we could pass our washing machine hoses through into the drain. . Builder sent painter to touch up around bathroom ceiling architraves due movement (was never supposed to have architraves as contract stated square set) and his advice was to simply paint over marks when they occur.

If we were to do it all over again we would choose a bigger and more tried and tested company to build for us. Other comparable homes in our area seem to have much more high spec fittings and appliances than we ended up with, had better consultation and customer service from the builders, and were finished ahead of time disregarding rain or holidays etc. We believe it would have been an easier build if there had been a project manager, or if the builder had not been so busy with other projects at the expense of ours. Even now we have not heard from the builder since we exchanged emails last December.

  • Build Stage: Post-Construction
  • Construction End Date: June 2017
Customer Service
Timeliness
Structural Integrity
Plumbing & Waterproofing
Electrical & Lighting
Flooring
Transparency
K-FAM
K-FAM

21/07/18: Builder is still yet to make contact.

K-FAM
K-FAM

August 2018: As builder did not return to fix damaged light switches after the 90 day warranty period, I rang the company who made them and they (bless them) sent someone out to replace the worst of them. The others we will replace in time.

K-FAM
K-FAM

May 2019: Still no hot water at all in the kitchen and never has been. Still no tiles to the porch. Shower stall still leaks water. Still no driveway or compensation despite builder stating he would compensate. Still missing external drain therefore that side still floods every time it rains. No compensation for the fence despite builder stating he would compensate. Still damaged wall showing under the paint. Still cheap paintwork that is unwashable. Still cheap light switches keep failing. Tastic in ensuite has failed @ 21mths. LED down lights in kitchen have failed @ 18mths. Items from 90 day warranty still not attended to. Builder has ignored all emails since December 2017.

K-FAM
K-FAM

25Nov2019: After waiting more than 2 years for the builder to send the plumber to fix the lack of hot water to the kitchen, we organised and paid for one ourselves. After much testing and head scratching they replaced some items and got hot water to our kitchen tap for the first time ever. We also paid an electrician to install a television antenna but he found that one of the aerial connections was missing so we had to pay to have it installed. The contract clearly stated it should have been provided. I messaged the builder on the 31/10 to say that we were ready for the payment for the fence that we had paid for in our contract, and also the long driveway and the tiling to the front porch and we haven't heard anything in response as yet. Two other neighbours have also made contact about the payment for their fencing..one was responded to immediately, and the other has so far been ignored as well. The two of us who have been ignored are the ones who paid in full. We will require the solicitor we engage to deal with these payments and remediation.

K-FAM
K-FAM

There was a large rain event on the evening of the 9th Feb 2020. Probably the hardest it has rained in years. Discovered water running out of the electrical box on the side of the garage wall. Rang ACTEW AGL .The person they sent opened the box and swung the front panel open and the water was coming up like a bubbler through the conduit behind the switches. After consultation with their supervisors they believed that water was getting into the box at street level and running through the conduit,down the driveway and into the electrical box. They stated there should be a "weep hole" provided in the conduit near a drain at the base of the garage wall (ACTEW are strict that one must be fitted by electricians ) but surmised that it may not have been installed. Choice is to drill out part of the garage wall to gain access or dig down to cabling in driveway and put in a weep hole there near a drain. Electrician quoted $600 to remedy.

K-FAM
K-FAM

June2020: Builder messaged 7/3/2020 stated would send an electrician. Nobody ever contacted or came. AGL suggested putting in a complaint to ACTPLA. After 3mths they sent Evoenergy to seal both ends of the conduit.

K-FAM
K-FAM

3/10/2020: Last post on this issue. Got word from ASIC today that Delta is in External Administration. Looks unlikely we will ever receive justice from them. We ran into the real estate agent, D, a year or so ago and he said that he keeps a mental note of those who has been wronged by the builders. At that time apparently he placed us third from the top. So for anyone who has been wronged by Delta, I hope you can take comfort in the fact that the real estate agent will feel sorry for you.

K-FAM
K-FAM

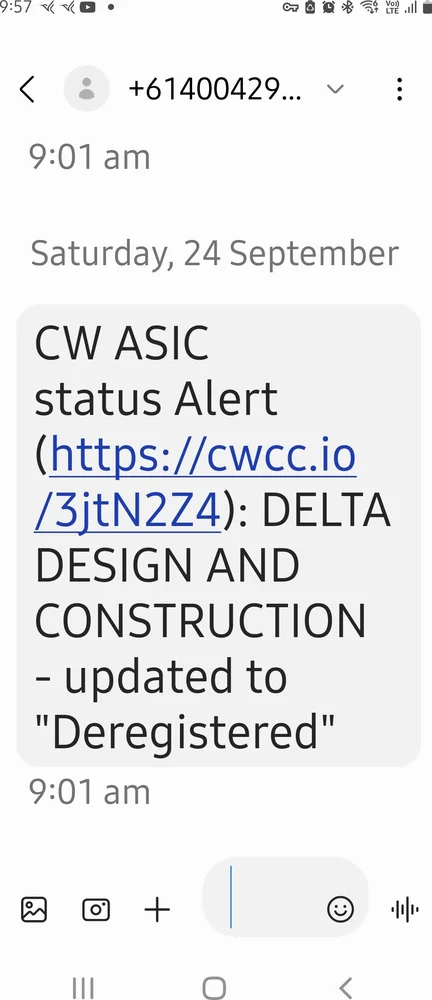

2022 UPDATE..ACCC messaged to say that Delta Design and Construction is now DEREGISTERED (see pics for screenshot). Principal and wife are now running a kitchen/home renovation company called HOMETEK RENOVATIONS AND EXTENSIONS (in Sydney, NSW).
